The MTA outlined plans Monday to maintain the extension of the Second Avenue Subway to East Harlem on monitor — even because it battles the Trump administration in federal courtroom over funding for the $7 billion undertaking.
The transit authority’s board will vote Wednesday to award the third of 4 contracts for the deliberate three-station extension of the Q line from 96th to one hundred and twenty fifth streets. The vote will come simply over per week after the MTA sued the federal authorities, charging that it’s withholding $60 million in promised funding.
Jamie Torres-Springer, president of MTA Building & Improvement, mentioned the beginning of labor hinges on “the uncertainty created by the federal authorities’s latest refusal to reimburse us” underneath a contractual settlement reached in 2023.
“We’re committing to delivering this undertaking on time and on price range and we proceed to take action and can accomplish that if we’re capable of comply with via and award this contract as quickly as potential,” Torres-Springer mentioned, including that the authority is “ready to maneuver shortly as soon as federal uncertainty is resolved.”
MTA officers described the looming work as “maybe essentially the most technically difficult” a part of the subway line extension, with 60-feet deep trenches set to be dug alongside Second Avenue from one hundred and fifth to one hundred and tenth streets throughout development that can take away 215,000 cubic yards of earth.
If all goes because the MTA hopes, the work would start later this yr.
All of that may be completed, officers mentioned, whereas retaining Second Avenue open to vehicular site visitors, and aiming to attenuate disruptions to buildings and companies alongside the trail of the deliberate route.
“Particular care can be taken to make sure the entry to the buildings, companies and colleges is repeatedly maintained,” mentioned Jignesh Shah, senior director for MTA Building & Improvement.
The contract is for excavation and development of the Q line’s 106th Road station. Work would decide up south of one hundred and fifth Road, connecting “tail tracks” simply north of the tip of the road’s first section to a tunnel that’s been mothballed for the reason that Seventies, when work on a line first proposed in 1929 was halted in the course of the metropolis’s monetary disaster.
“It fulfills a promise virtually a century previous to deliver subway service to East Harlem,” Torres-Springer mentioned.

The primary section of the Second Avenue Subway opened in 2017, with cavernous new stations constructed at 72nd, 86th and 96th streets.
However now, the destiny of the undertaking is snarled in a courtroom struggle with the Trump administration, with the MTA charging that the alleged breach of contract threatens the timetable for the long-planned subway extension.
In accordance with the lawsuit filed final week, the breach “has required the MTA to divert thousands and thousands of {dollars} away from different essential transportation tasks with a view to fill the hole.”
“Their refusal to honor the total funding grant settlement for the Second Avenue Subway is a farce,” Brian Fritsch, affiliate director for the Everlasting Residents Advisory Committee to the MTA, testified Monday at conferences of the authority’s board. “And we applaud Governor Hochul and the MTA for taking the feds to courtroom.”
The Trump administration has been essential of transit development prices, whereas MTA officers have mentioned the authority is working to include prices throughout its tasks.
“The Division is dedicated to making sure taxpayers {dollars} are used effectively, in keeping with the legislation and our structure,” a spokesperson for the federal Division of Transportation mentioned.
The feds final yr froze funding on the subway extension, in addition to the Gateway undertaking to construct a brand new rail tunnel between New York and New Jersey, questioning whether or not the tasks are according to a USDOT rule on deprived enterprise enterprises. Work on the Hudson River rail tunnel resumed final month amid one other federal courtroom struggle.
MTA officers mentioned work on the primary contract for the subsequent section of the Second Avenue Subway is “aggressively advancing.”
“Our utility relocations have superior considerably,” mentioned Matthew Zeetwoch, vice chairman and program government at MTA Building & Improvement. “Fuel, energy, water, sewer and telecommunications are quickly being relocated.”

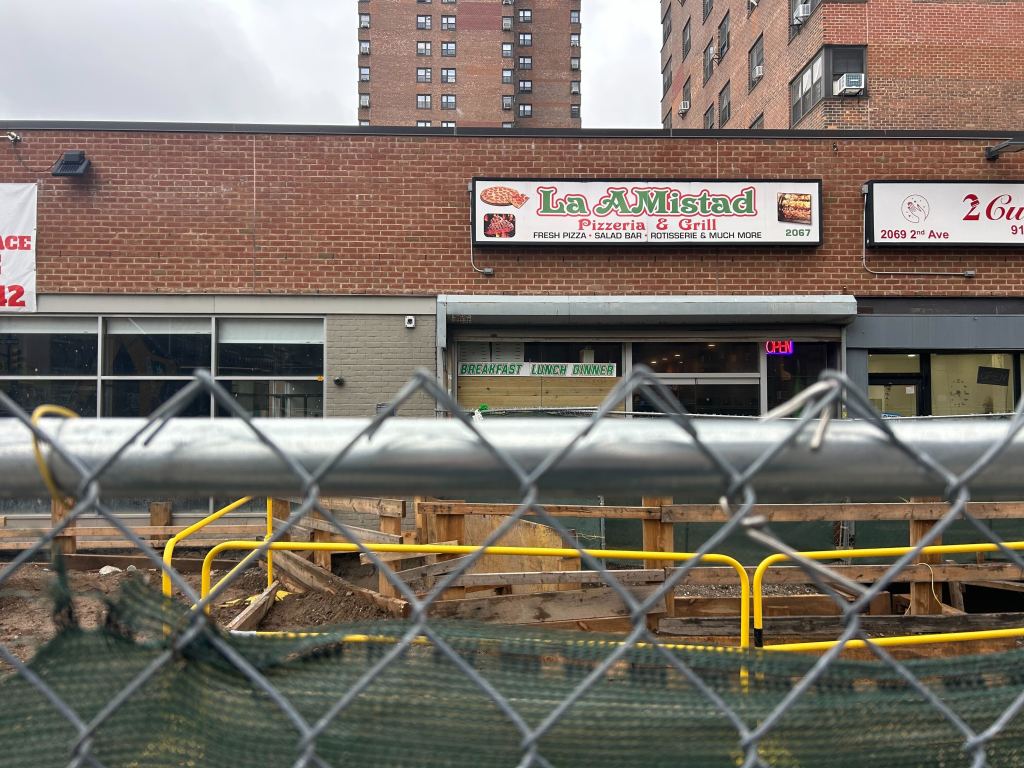

At La Amistad Pizzeria & Grill, whose storefront at 106th Road and Second Avenue is already hid by development fencing for the subway undertaking, proprietor Ediberto Rendon mentioned the enterprise is now in “survival mode.”
Rendon mentioned he fears the eight-year-old enterprise might not outlast the development.

“I’m all for it, the factor is it’s actually hurting me proper now,” he informed THE CITY. “That’s the factor I really want to determine how one can assault — my regulars know I’m right here, however I don’t get new prospects.”
A number of blocks north, one other shopkeeper mentioned her household’s small grocery retailer is struggling behind the fencing even earlier than the heavier work begins.
“Proper now, it’s a miracle if we get new prospects due to all of this,” mentioned Adela Zamora, whose household owns Raspberry Deli & Grocery Co. “When the precise digging begins, it’s going to be much more problematic — extra individuals, extra development all day lengthy.”
Zamora mentioned she is hopeful that the extension of the subway to East Harlem will finally be a boon for the neighborhood and the town.
“I’m relying on it, truthfully,” she mentioned. “Nevertheless it’s undoubtedly a battle.”
